Airport Construction

Runway Safety Area Project Update

The Runway 10/28 Safety Area Project continues to progress, with construction activities moving forward as planned.

Current Project Impacts

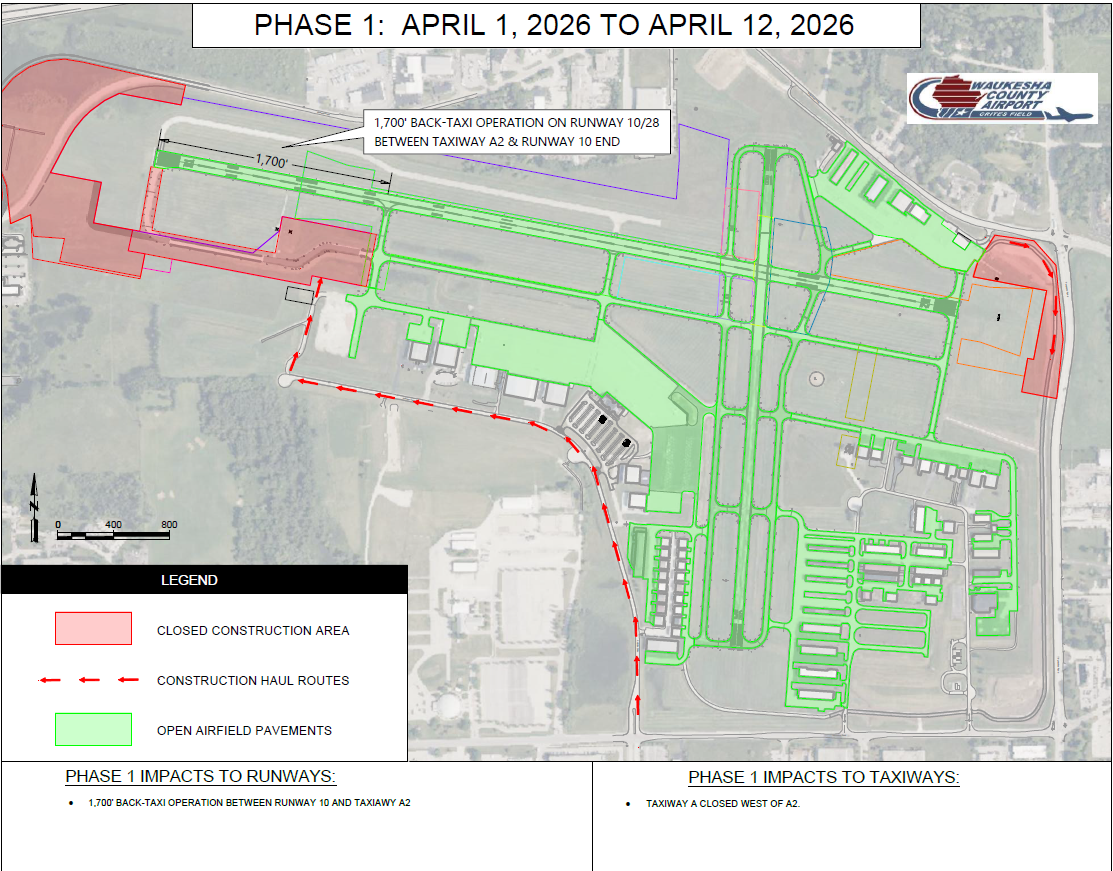

  • Taxiway A west of Taxiway A2 remains under construction. Aircraft departing on Runway 10 will need to back taxi to the runway end.
  • Runway 28 RNAV (GPS) approach is available.
  • Runway 10 ILS approach remains out of service and is anticipated to be available October 29, following completion of the FAA flight check.

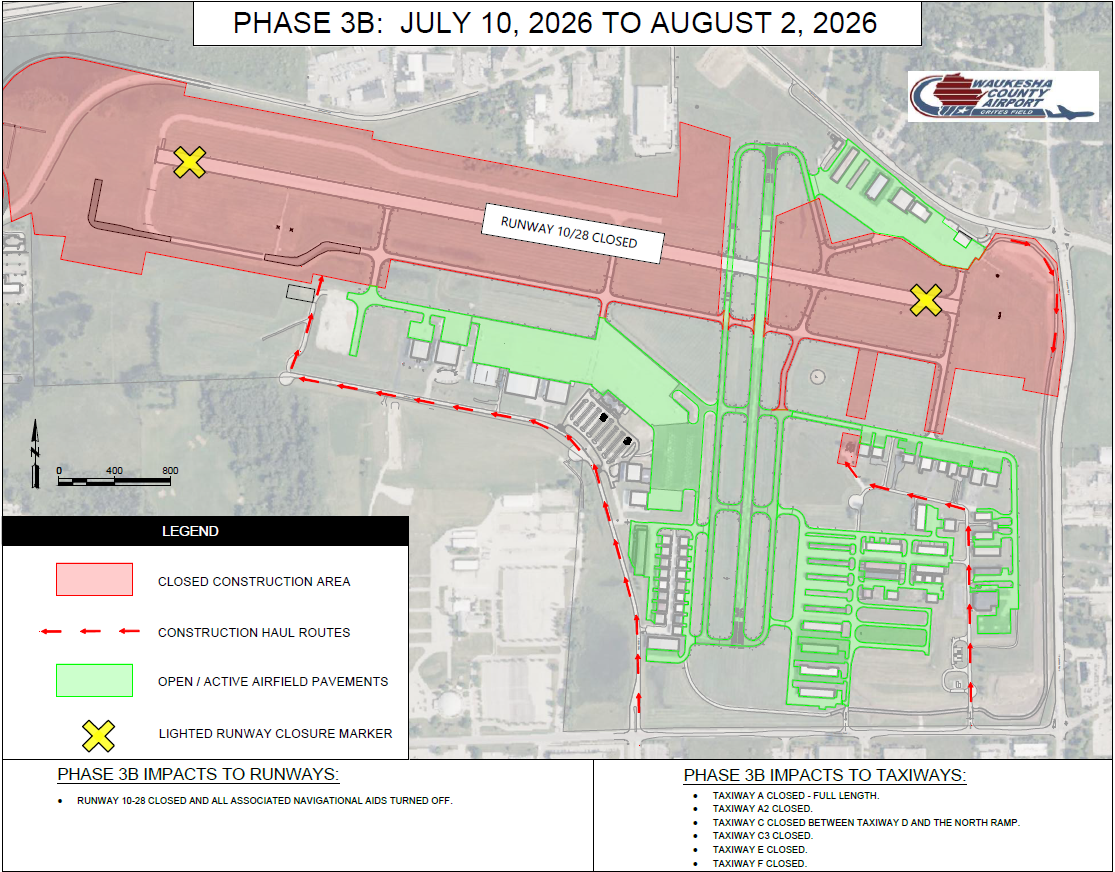

  • Additional movement area closures may be necessary as different phases of the project progress. Any operational impacts will be communicated as information becomes available.

Upcoming Milestone

October 29: Runway 10/28 instrument approaches are anticipated to be re-published following completion of the FAA flight check.

Staying Informed

We understand this project affects our airport users, tenants, and the surrounding aviation community. Please continue to monitor this page for updates as the project progresses or contact Kurt Stanich, Airport Manager, with questions at kstanich@waukeshacounty.gov.

If you would like to be added to our email notification list, please email Sarah McCalvy at smccalvy@waukeshacounty.gov.
