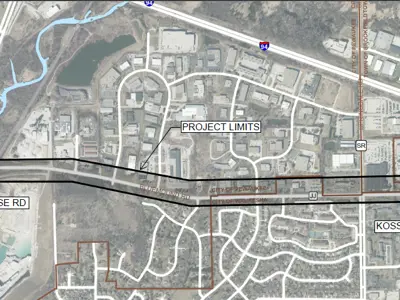

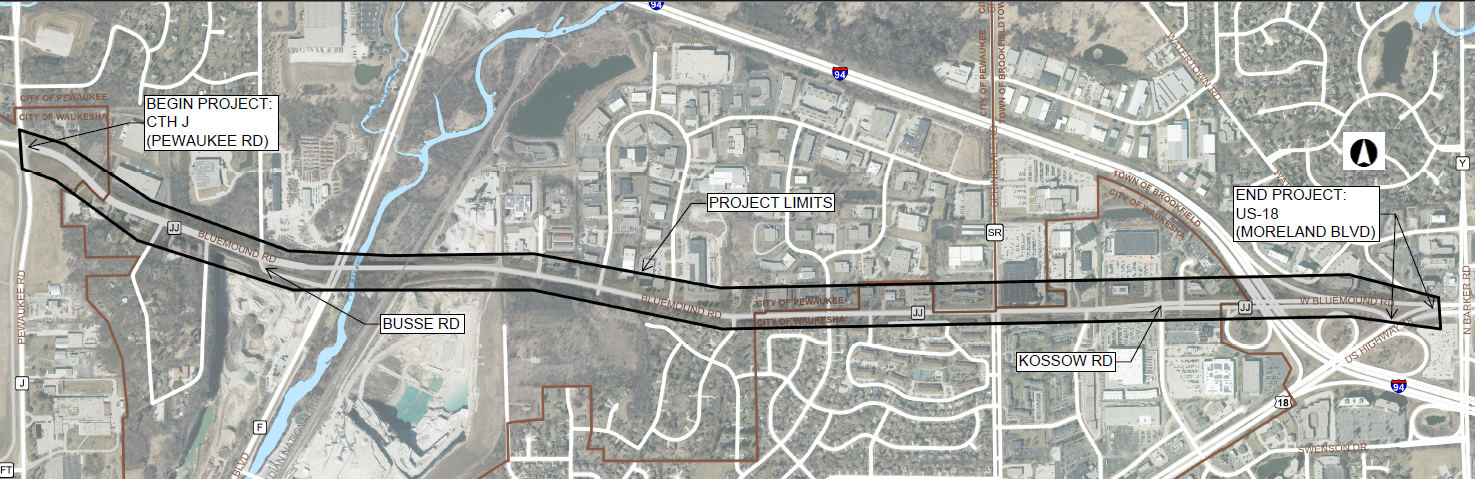

View a map that shows detour alternate routes during construction.
County Highway JJ
From CTH J (Pewaukee Rd) to USH-18
City of Waukesha, City of Pewaukee, Town of Brookfield
Welcome to Waukesha County Public Works' info page for the 2026 project on CTH JJ (Bluemound Rd).
Please find regular updates on project impacts to residents, businesses, and Waukesha County drivers.
Questions and comments? Contact us!
Greg Luedtke
Project Manager
262-548-7846
View the Project Summary as of December 11, 2025
CTH JJ (Bluemound Road)
CTH J to US-18
Waukesha County
Project I.D. 25-2758(13)
Project Updates are also included below.
Project Sequence of Operations
View the Project Sequence of Operations
25-2758(13) CTH JJ (J to USH-18) Rehabilitation
*Scheduled durations listed are subject to change and are weather dependent.
Project Updates are also included below.
Public Information Meeting May 28, 2026

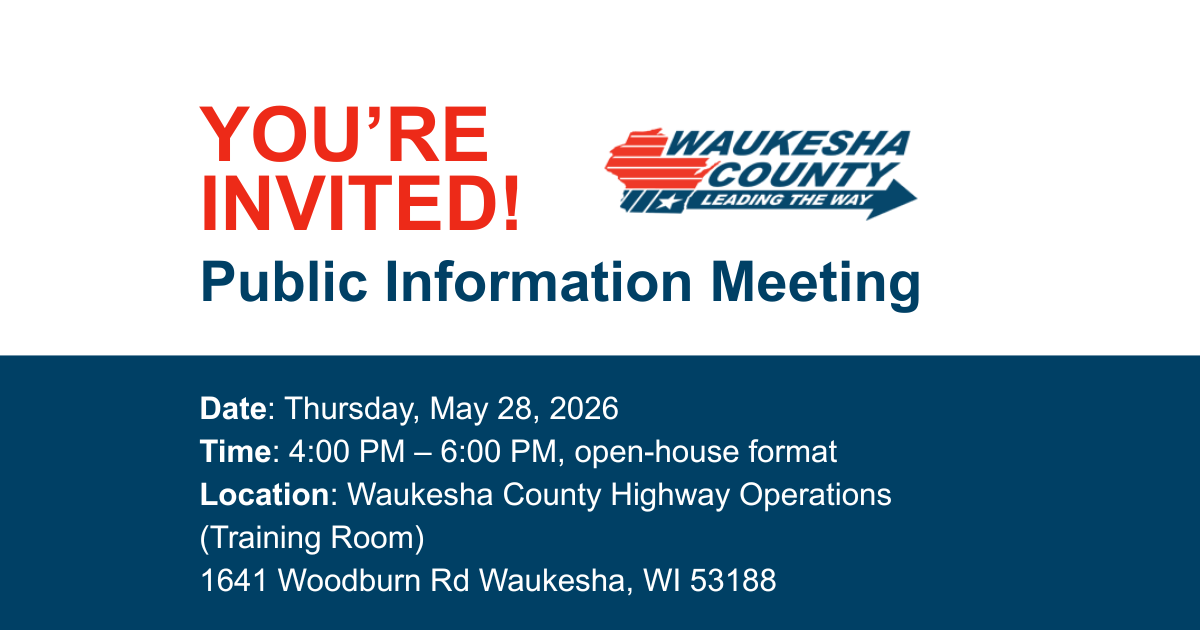

View the Public Information Meeting Invite
Date: Thursday, May 28, 2026
Time: 4:00 PM – 6:00 PM, open-house format
Location: Waukesha County Highway Operations (Training Room)
1641 Woodburn Rd
Waukesha, WI 53188
Project Updates
August 5, 2026
Stage 2 – Complete
County Highway JJ is open from Pewaukee Road to Busse Road.
Stage 3 – Complete
County Highway JJ is open from Busse Road to Springdale Road.
Stage 4 – Complete
County Highway JJ is open from Springdale Road to Kossow Road.
Stage 5A – Currently Under Construction
- Expected duration: approximately 1.5 weeks (subject to change).
- County Highway JJ Eastbound will be closed to through traffic from Kossow Road to USH-18.
- Access to Plaza Court will be maintained. Local businesses should access Plaza Court from the west at the JJ and Kossow Road intersection.
- Anticipated reopening on Monday, August 10 (subject to change)
Project Completion
Construction is anticipated to be complete during the third week of August.
July 23, 2026
Stage 2 – Complete
County Highway JJ is open from Pewaukee Road to Busse Road.
Stage 3 – Currently Under Construction
County Highway JJ is closed to through traffic from Busse Road to Springdale Road.
Access to local businesses is maintained. Please enter the work zone from Springdale Road.
Construction began Monday, July 20, and is expected to last approximately 1.5 weeks (subject to change).
Once construction is complete, County Highway JJ will reopen from Busse Road to Springdale Road.
Stage 4 – Tentatively Scheduled to Begin July 30
Expected duration: approximately 1.5 weeks (subject to change).
County Highway JJ will be closed to through traffic from Springdale Road to Kossow Road.
Access to local businesses will be maintained.
Once construction is complete, County Highway JJ will reopen from Springdale Road to Kossow Road.
Stage 5 – Tentatively Scheduled to Begin August 6
Expected duration: approximately 2 weeks (subject to change).
Project Completion
Construction is anticipated to be complete during the third week of August.
July 14, 2026
Beginning July 20, Bluemound Rd (CTH JJ) construction will move into Stage 3.
July 1, 2026
Beginning July 15, Bluemound Rd (CTH JJ) construction will move into Stage 3.
During this stage, Bluemound Road (CTH JJ) will be fully closed between Redford Boulevard (CTH F) and Springdale Road (CTH SR). Work will include removing the existing asphalt pavement, repaving the roadway, and installing new pavement markings.
Local and business traffic only will be allowed within the closure. Please enter and exit the closed area at Springdale Road (CTH SR). During active construction, flaggers will assist local traffic enter and exit at Springdale Road (CTH SR).
Residents who live on adjacent side roads should access their neighborhoods via Ruben Drive or Rambling Rose Road from Springdale Road.
Businesses located on Westmound Drive, Eastmound Drive, and Saratoga Drive should use Johnson Drive at Springdale Road (CTH SR) to enter and exit.
Through traffic should follow the posted alternate route.
Stage 3 is anticipated to be completed by July 25.
*The schedule is subject to change based on weather or field conditions.
June 26, 2026
Stage 2 of the CTH JJ rehabilitation project has begun. This stage includes the closure of CTH JJ between CTH J and CTH F for asphalt pavement removal, repaving, and pavement marking installation.
During the closure, the roadway will remain open to local traffic only. Local traffic may enter and exit the closure area via North Busse Road or South Busse Road. Through traffic should use the designated detour route. CTH F and CTH SR may also be used to travel around the closure.
Stage 2 is anticipated to be completed by July 2.
The schedule is subject to change based on weather and field conditions.
June 5, 2026
A map is now included in the tabs above that shows detour alternate routes during construction.
June 4, 2026
News release included within tab above.
May 18, 2026
New Materials for your review: Public Information Meeting Details and Project Sequence of Operations are now included. Click the tabs above to review.
December 11, 2025
Project Summary included within tab above.
